logo gr
logo en
Web Portal - Attiko Metro S.A.
ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε.ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε.ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε.
ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε.ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε.ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε.

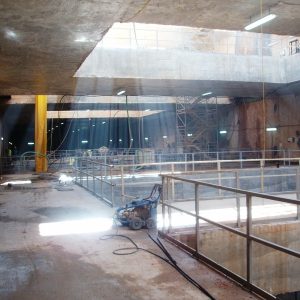

Thessaloniki Base Project progress

February 2009

The first TBM continues its underground trip without any obstruction, while the assembly of the 2nd TBM will be soon completed. The construction of diaphragm walls was completed at DEMOKRATIAS Station and at the branching of the Metro Line to Stavroupoli, while the relevant works at SYNTRIVANI Station and at the forestation of NEOS SIDIRODROMIKOS […]
Read More

January 2009

The running ot the first Tunnel Boring Machine commenced, while the assembly of the second TBM is in progress. The construction of diaphragm walls is at a completion stage: DEMOKRATIAS Station:completed at a percentage of 99% SYNTRIVANI Station:completed at a percentage of 81% Forestation of NEOS SIDIRODROMIKOS STATHMOS:completed at a percentage of 95% Branching towards Stavroupoli:completed […]
Read More

December 2008

The trial running ot the first Tunnel Boring Machine commenced. The construction of diaphragm walls is at an advanced stage: Forestation of NEOS SIDIRODROMIKOS STATHMOS:completed at a percentage of 95% DEMOKRATIAS Station:completed at a percentage of 91% SYNTRIVANI Station:completed at a percentage of 92% AGHIA SOFIA Station:completed at a percentage of 51% Branching towards Stavroupoli:completed at a […]
Read More

Νovember 2008

The assembly of the first Tunnel Boring Machine was completed. The construction of diaphragm walls is at an advanced stage: NEOS SIDIRODROMIKOS STATHMOS: completed at a percentage of 93% DEMOKRATIAS Station: completed at a percentage of 76% SYNTRIVANI Station: completed at a percentage of 91% AGHIA SOFIA Station: completed at a percentage of 45% Branching […]
Read More

October 2008

The assembly of the first Tunnel Boring Machine is at a completion phase. The construction of diaphragm walls at Syntrivani will be completed soon (currently completed at a percentage of 86%). In the area where the orphanage “Alexander the Great” was located, excavation works commenced for the construction of a building at the expense of AM […]
Read More

September 2008

At the end of the year the assembly of the first Tunnel Boring Machine is expected to be completed and its trial run will commence. At the same time, the assembly of the second Tunnel Boring Machine is provided for to commence in the early 2009. Preparatory works for the installation of the Contractor at […]
Read More

August 2008

The assembly of the Tunnel Boring Machine has commenced at NEOS SIDIRODROMIKOS STATHMOS Station. The main construction works at NEOS SIDIRODROMIKOS STATHMOS, DIMOKRATIAS, VENIZELOU, SYNTRIVANI and AGHIA SOPHIA Stations advance at a rapid pace. Until the present day, the archaeological excavation works executed for the Metro construction have covered a total surface of 7000m2.
Read More

July 2008

The construction of diaphragm walls at DEMOKRATIAS Station is at a completion stage. The construction of diaphragm walls at SYNTRIVANI Station is at an advanced stage (completed at a percentage of 71%), while the excavation works at VENIZELOS Station have recently commenced. The construction of the raft at the start-up shaft of the two tunnel […]
Read More

June 2008

The execution of piling works is in progress (completed at a percentage of 35%) at the entrances/exits of VENIZELOS Station, while respective works at AGHIA SOFIA Station commenced. Archaeological finds were revealed at the southeastern side of SINTRIVANI Station. The excavation of the start-up shaft of the TBM in the area of NEOS SIDIRODROMIKOS STATHMOS […]
Read More

May 2008

The construction of diaphragm walls at SINTRIVANI Station (completed at a percentage of 55%) and at DEMOKRATIAS Station (completed at a percentage of 35%) is at an advanced stage, while the installation of piles at the entrances/exits of VENIZELOS Station commenced. Worksite installation of the contracting consortium at PAPAFI Station is in progress. The construction […]
Read More
WCAG

Δομοστατική Καταγραφή Κτηρίων

για τη Νέα Γραμμή 4A
