Kalamaria Project progress

September 2025

  • Kritis Shaft: All infrastructure related activities of this section have been completed. In progress are the works pertaining to the completion of fire detection, communication systems, air-conditioning and hydraulic systems.
  • NOMARHIA Station: All infrastructure related activities of this Station have been completed. In progress are the works pertaining to the completion of architectural finishes, hydraulics and reinstatement at street level. The medium voltage electrotechnical works at the Station are at the completion stage along with automatic fire extinguishing and escalators systems. In progress are the works pertaining to the completion of low voltage distribution, sewage-pumping stations, fire detection, lighting, lifts and communication systems.

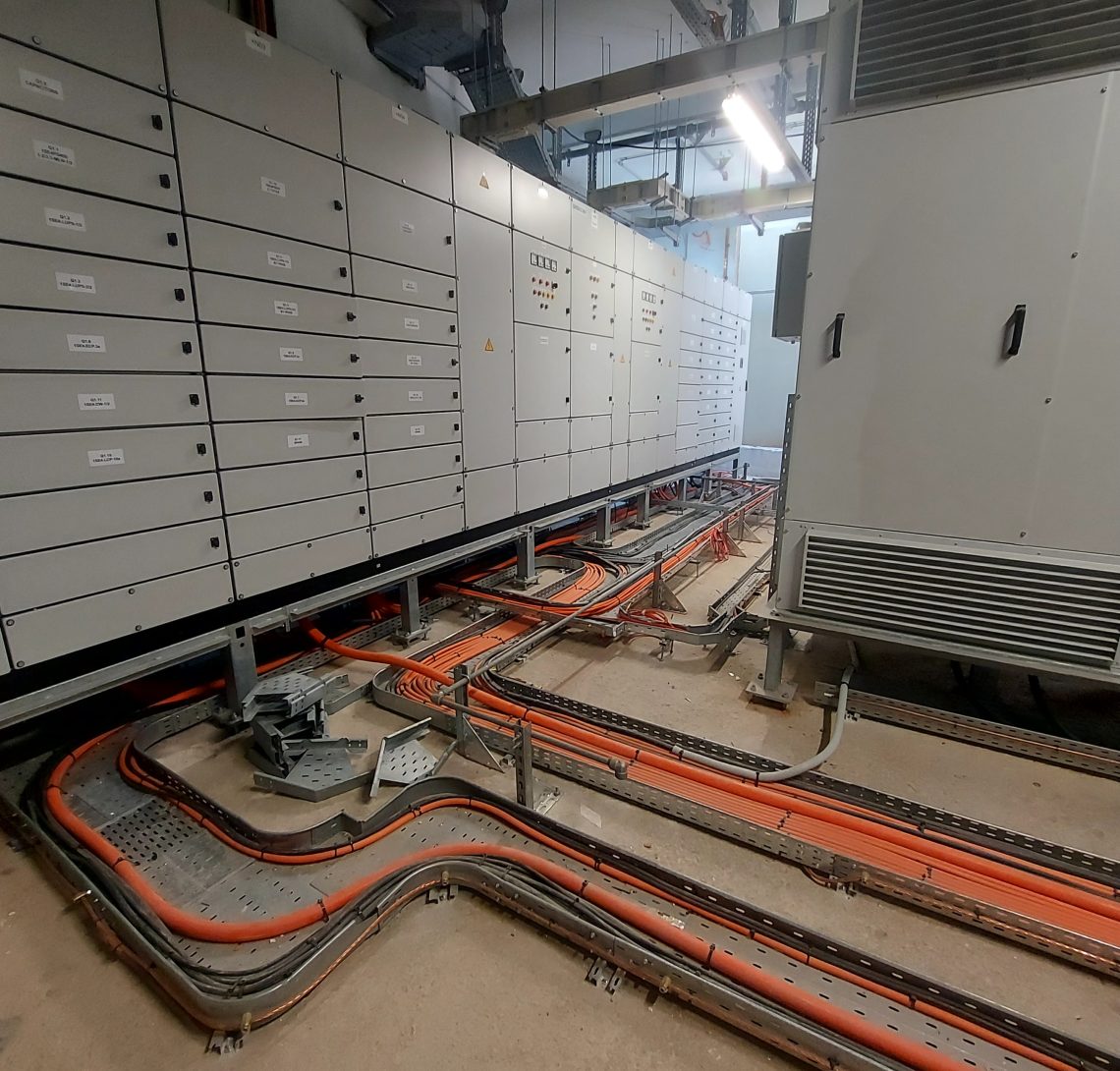

  • KALAMARIA Station: All infrastructure related activities of this Station have been completed. In progress are the works pertaining to the completion of architectural finishes, hydraulics and reinstatement at street level. At their completion stage are the electromechanical works pertaining to medium voltage, automatic fire extinguishing and escalators systems. In progress are the works pertaining to the completion of low voltage distribution, fire detection, air-conditioning–ventilation systems, lifts and communication systems.
  • ARETSOU Station: All infrastructure related activities of this Station have been completed. In progress are the works pertaining to the completion of architectural finishes and reinstatement at street level.  At their completion stage are the electromechanical works pertaining to medium voltage, air-conditioning, and escalators systems. In progress are the works pertaining to the completion of low voltage distribution, fire detection and lighting, lifts and communication systems.
  • Pontou Shaft: All infrastructure related activities of this section have been completed, while in progress are the works pertaining to the completion of roller shutters.
  • NEA KRINI Station: All infrastructure related activities of this Station have been completed. In progress are the works pertaining to the completion of architectural finishes and reinstatement at street level. At their completion stage are the electromechanical works pertaining to firefighting and escalators systems. In progress are the works pertaining to the completion of low voltage distribution, air-conditioning–ventilation systems, lifts and communication systems.
  • MIKRA Station: All infrastructure related activities of this Station and both Crossovers have been completed. In progress are the works pertaining to the completion of architectural finishes and reinstatement at street level. At their completion stage are the electromechanical works pertaining to medium voltage, firefighting, automatic fire extinguishing and escalators systems. In progress are the works pertaining to the completion of low voltage distribution, air-conditioning, lifts and communication systems.
  • Tunnels: All infrastructure and trackwork related activities of this section have been completed. At their completion stage are the works pertaining to lighting, firefighting and communication systems. In addition, at their completion stage are the electromechanical works pertaining to medium voltage cabling, earthing systems, tunnel traction power system, firefighting and central cabling.
