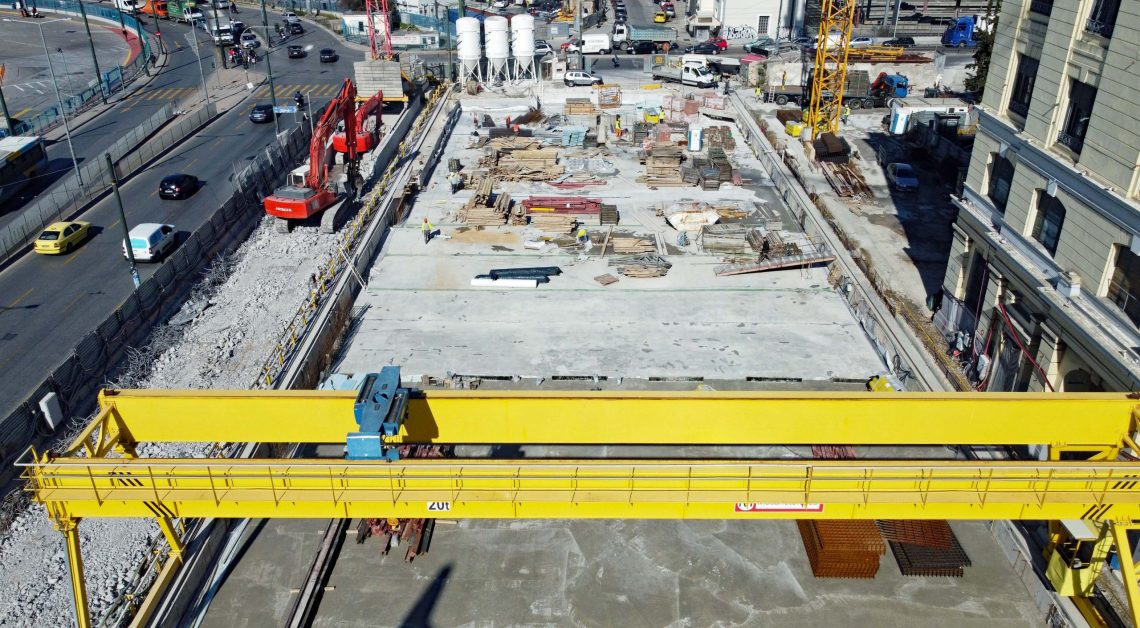

Piraeus Project progress

FEBRUARY 2021

TZAVELA SHAFT

The following works have been completed:

  • Completion of the permanent lining of the shaft and of the connecting tunnel.

The following works are in progress:

  • Masonry walls.

MANIATIKA STATION

STATION’s OPEN CUT

The following works have been completed:

  • Completion of the permanent lining of the shaft.

The following works are in progress:

  • Waterproofing of the roof slab.
  • Masonry walls – plastering works at levels -4, -3, -2 and -1.
  • Architectural finishes – Painting works at levels -4, -3
  • Industrial flooring at levels -4, -3 and -2.

MAIN TUNNEL OF THE STATION (ΝΑΤΜ)

The following works have been completed:

  • Permanent lining of the station’s main tunnel.

The following works are in progress:

  • Secondary concreting in platforms.

UNDERGROUND NATM SECTIONS OF THE STATION (NATM)

The following works have been completed:

  • Completion of excavation works and temporary retaining of the east elevator.
  • Completion of construction of the permanent lining of the east elevator of the station.

MELA SHAFT

The following works have been completed:

  • Waterproofing of the NATM connecting tunnel.
  • Concreting of the final lining of the NATM tunnel (vault + reverse arch).

The following works are in progress:

  • Concreting of the foundation slab (pumping station) and of the perimeter walls.

PIRAEUS STATION

The following works have been completed:

  • Waterproofing of the main station.
  • Concreting of the main station.
  • Removal of all struts.

The following works are in progress:

  • Construction of architectural finishes (masonry walls, plastering, painting works, floor filling, industrial flooring).
  • Installation of formwork, reinforcement and concreting of interior staircases.
  • Excavation and temporary retaining of access 1.
  • Excavation of entrance 2.
  • Installation of waterproofing at the roof slab.

ROLOI SHAFT & NATM ACCESS TUNNEL

The following works have been completed:

  • Construction of permanent lining.

The following works are in progress:

  • Concreting of the shaft’s roof slab (completed).

DIMOTIKO THEATRO STATION

MAIN STATION – AGHIOU KONSTANTINOU SQUARE

The following works have been completed:

  • Sealing of the temporary pumping station.

The following works are put on hold:

  • Installation of doors at E/M level.

The following works are in progress:

  • Cleaning works.
  • Cement mortar laying works at the ticketing level and the E/M floor.
  • Installation of floor granite slabs at the platform level.
  • Installation of floor and wall tiles in the personnel areas (ticketing level).
  • Painting preparatory works at staircases 7 and 8.

UNDERGROUND SECTION OF THE STATION

The following works have been completed:

  • Concreting of the permanent lining, walls and platform slab.

The following works are in progress:

  • Installation of floor granites.

DIMOTIKO THEATRO VENTILATION SHAFT

The following works have been completed:

  • Concreting of the permanent lining.

RALLIOS SHAFT VENTILLATION TUNNEL

The following works have been completed:

  • Concreting of the permanent lining

The following works are in progress:

Repairs to concreting works and application of polyurethane.
