Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa

MARCH 2022

TZAVELA SHAFT

The following works have been completed:

  • Architectural finishes – painting works at the staircase (walls, floors).
  • Construction of sound absorbing plaster.
  • Installation of staircase balustrades.
  • Installation of the entrance hatch at street level.
  • Reinstatement of Tzavela and Lakonias Streets, opening to the

MANIATIKA STATION

STATION’s OPEN CUT

The following works have been completed:

  • Construction of partition walls at the station’s expropriation limits (street level).
  • Surface reinstatement (construction of sidewalk at Etolikou and Mavromichali Streets).

The following works are in progress:

  • Architectural finishes – Painting works at levels -4, -3, -2, -1.
  • Installation of metal structures in room 3.14 – 3.16.
  • Installation of false ceilings and steel cladding (panels) on the walls of the main areas at the station’s level -1.
  • Installation of glass panes at levels -1, -2.
  • Installation of lift at street level.
  • Construction of flower beds’ walls, slab paving works and installation of paving stones and lighting (at street level).
  • Installation of lighting at Etolikou Street sidewalk.

MAIN TUNNEL OF THE STATION (ΝΑΤΜ)

 The following works have been completed:

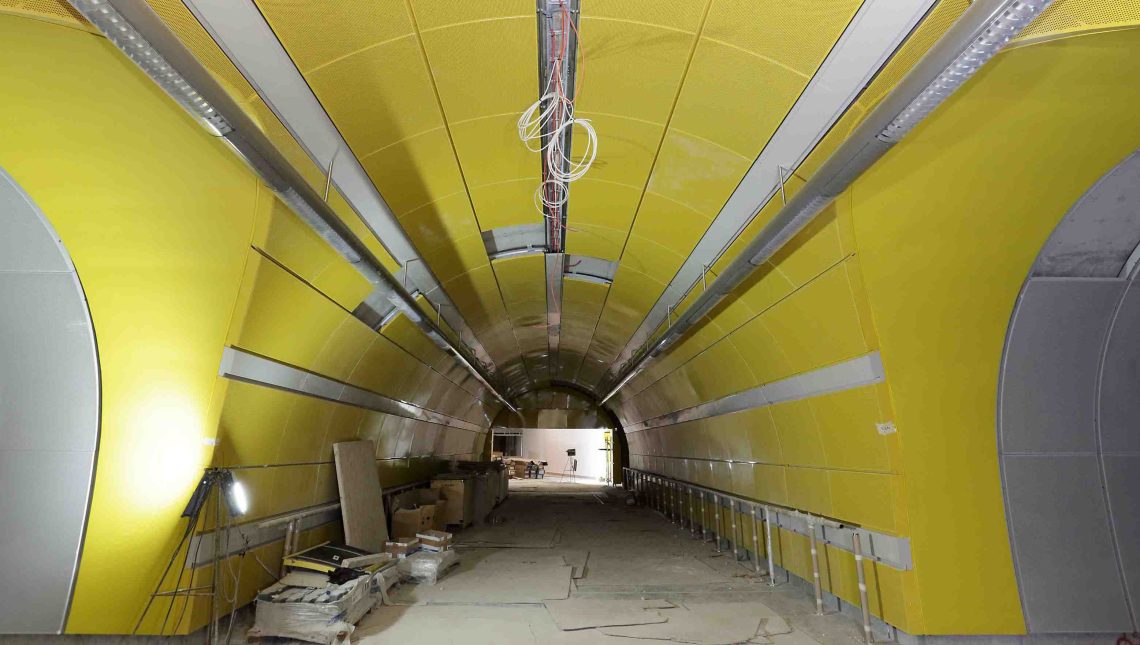

  • Steel cladding on the roof and side coverings.
  • Installation of information boards and signage at the platforms.

UNDERGROUND NATM SECTIONS OF THE STATION (NATM)

The following works have been completed:

  • Installation of granites at the platforms.

The following works are in progress:

  • Installation of granites and stainless steel ducts at the staircases.
  • Installation of lining (made of steel and gypsum boards) at the access tunnels of the station and at the upper transverse access gallery.

SOUTH VENTILATION SHAFT OF THE STATION (Koumoundourou Street)

The following works have been completed:

  • Construction of perimeter wall at the boundaries of the expropriation.
  • Construction of metal structures at K.P. +8.36 and +21.00.
  • Application of sound absorbing plaster.
  • Installation of staircase balustrades.
  • Architectural finishes (painting works).
  • Installation of access hatch at the street level.
  • Road surface reinstatement at Koumoundourou Street
  • Surface reinstatement (construction of sidewalk and of surrounding area).

NORTH VENTILATION SHAFT OF THE STATION (Dimitrakopoulou Street)

The following works have been completed:

  • Installation of metal structures at K.P. +8.08 and +24.98.
  • Construction of sound absorbing plaster.
  • Architectural finishes (painting works).
  • Installation of staircase balustrades.
  • Installation of the entrance hatch at street level.
  • Construction of perimeter wall at the eastern boundary of the expropriation.

The following works are in progress:

  • Surface reinstatement (construction of sidewalk and of surrounding area).

MELA SHAFT

The following works have been completed:

  • Concreting of pit.

The following works are in progress:

  • Installation of the staircase handrails and balustrades.

PIRAEUS STATION

The following works have been completed:

  • Concreting of main station (works at a small section of the roof slab and at the stairs towards the street level are pending).

The following works are in progress:

  • Excavation and temporary retaining of the tunnel for the lift of entrance 3.
  • Construction of architectural finishes (installation of granites at level -1 and at the public staircase, construction of plastering works at level -2, installation of ceramic tiles at level -1, installation of doors at level -1, installation of false ceiling at levels -1 and -3, painting works at level -2 and at the staircases, filling works at level -1, wall cladding at platform level, installation of galvanised steel panels at level -3, construction of gypsum boards at level -2 installation of handrails and balustrades at the staircases).
  • Electromechanical works at levels -1 and -2 and installation of air exhaust duct at the platforms’ level (-3).
  • Waterproofing of accesses 1, 2 & 3.
  • Concreting of exterior and interior parapet walls in access 3.
  • Reinforcing and concreting of parapet walls at street level and of the staircases in accesses 1 and 2.
  • Concreting of a section of the roof slab.
  • Demolition of pile cap beam to the south under the pedestrian bridge.
  • Removal of struts at access 3.

ROLOI SHAFT & NATM ACCESS TUNNEL

The following works have been completed:

  • Sealing of the temporary pumping station.
  • Installation of emergency exit hatch at street level.

DIMOTIKO THEATRO STATION

MAIN STATION – AGHIOU KONSTANTINOU SQUARE

The following works have been completed:

  • Sealing of the temporary pumping station.
  • Traffic reinstatement at V. Georgiou Street.
  • Traffic reinstatement at Karaiskou Street.

The following works are in progress:

  • Erection of new building crane in the square.
  • Reinstatement at street level (construction of inner parapet walls at the square, backfilling – compaction, marble cladding works in the square).
  • Installation of wall panels at the ticketing and at mechanical floor levels.
  • Installation of stainless steel cladding at the platforms level.
  • Installation of false ceiling panels at the platforms level.
  • Installation of floor granite at the platforms level.
  • Preparation for the execution of floor painting works at staircases 7 and 8.
  • Construction of fire-rated glass panes at platform level.
  • Conservation of the Project’s archaeological finds.

STAIRCASE GALLERIES

The following works are in progress:

  • Installation of supports for the wall and ceiling panels at the staircases.

KORAI SQUARE ENTRANCE AND ACCESS GALLERY

The following works have been completed:

  • Construction of lift housing structure at street level.

The following works are in progress:

  • Installation of supports for the wall and ceiling panels according to the design for the display of the archaeological finds.

BAKOYIANNI SQUARE ENTRANCE AND ACCESS GALLERY

The following works are in progress:

  • Transfer of the antiquities in the floor recess displaying the pebbled floor.
  • Installation of wall cladding (mirrors) according to the design for the display of the archaeological finds.
  • Landscaping works at the flower beds (street level).

DIMOTIKO THEATRO VENTILATION SHAFT (RALLIOS SHAFT) AND VENTILATION GALLERY

The following works have been completed:

  • Sealing of the temporary pumping station.
  • Sidewalk reinstatement on V. Georgiou Street.

The following works are in progress:

  • Construction of balustrades at the staircase.
  • Installation of a waterproof hatch at street level.

TRIPLE TRACK NATM TUNNEL

Works have been completed.

DELIGIANNI SHAFT

The following works have been completed:

  • Disassembly of building crane.

The following works are pending:

  • Backfilling – compaction.
  • Pile cap beam and other concrete structures demolition at surface level.

The following works are in progress:

  • Construction of inner parapet walls at the square.

PANEPISTIMIO SHAFT & VENTILATION TUNNEL

The following works are in progress:

  • Waterproofing of the roof slab (concreting for the protection of the membrane).
  • Preparation for painting works at the shaft.
Print Friendly, PDF & Email
WCAG
