ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε. – ELLINIKO METRO S.A.

Piraeus Project progress

APRIL 2020

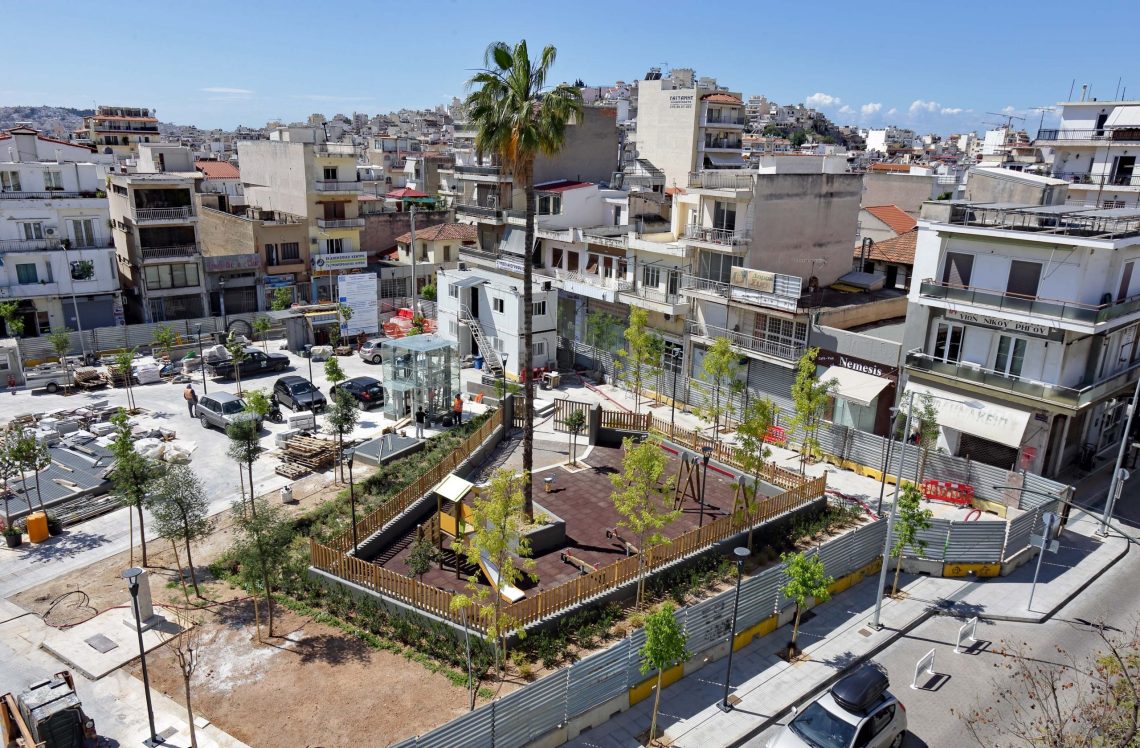

AGHIA VARVARA STATION

 The following works are in progress:

  • Wall and columns cladding (metal, glass etc.)
  • Square reinstatement (installation of marbles)
  • Other reinstatement works at street level
  • Station signs and other signs
  • Installation of metal false ceilings
  • Architectural finishes (installation of balustrades and handrails)
  • Other architectural finishes.

MEGALOU ALEXANDROU SHAFT

The following works are still pending:

  • Planting (street level).

TAXIARCHON SHAFT

The following works are in progress:

  • Painting works
  • Configuration at street level.

KORYDALLOS STATION

The following works are in progress:

  • Wall and Columns cladding
  • Installation of false ceilings
  • Installation of balustrades
  • Installation of roller shutters
  • Installation of irrigation system at street level
  • Installation of signage
  • Installation of stainless steel structures
  • Repair of painted surfaces and worn granites
  • Installation of Station entrances’ sheds
  • Installation of lift at street level
  • Configuration at street level (Eleftherias Square)

NIKEA STATION

MAIN STATION

The following works are in progress:

  • Treatment and re-painting of industrial floors in E/M areas
  • Installation of sheds’ metal frame at the natural light shaft
  • Cladding of vertical items using metal panels
  • False ceilings
  • Preliminary works for the installation of stainless steel handrails at the escalators in the concourse area.

NATM TUNNEL FOR STATION VENTILATION

The following works have been completed:

  • Construction of the final lining
  • Painting works (still pending are painting works at the connection with TBM tunnel)
  • Construction of industrial floor.

MANIATIKA STATION

STATION’s C/C

The following works have been completed:

  • Waterproofing of perimeter paramet walls
  • Permanent lining of the foundation (level -4)
  • Permanent lining of E/M slab (level -3)
  • Permanent lining of the ticketing area slab (level -2)
  • Permanent lining of staircace S4
  • Permanent lining of E/M slab (level -1).

MAIN TUNNEL OF THE STATION (ΝΑΤΜ)

The following works have been completed:

  • Permanent lining of the station’s main tunnel
  • Permanent lining of the deepening area
  • Permanent lining of the northern and southern headwall
  • Construction of parapet walls and platform slabs
  • Secondary grouting of the vault of the main station tunnel.

PIRAEUS STATION

STATION

The following works have been completed:

  • Installation and prestressing of struts for temporary retaining up to level 5.
  • Installation of waterproofing underneath the foundation at bays 1, 2, 3, 4 (still pending is the pumping station)
  • Concreting of the foundation slab at sections 1, 4.

The following works are in progress:

  • Installation of the foundation slab’s reinforcement and concreting at sections 2, 3 and 5N
  • Excavation of the station, section 5B (last phase) and of the pumping station
  • Improvement and installation of waterproofing at sections 5N and 5B
  • Installation of reinforcement at the foundation slab at section 5B
  • Concreting of platform walls at bays 1 and 2
  • Concreting of the non reinforced concrete filling at bays 5N, 2 and 3
  • Installation and pre-loading of 10 struts of the temporary retaining at level 6.

DIMOTIKO THEATRO STATION

MAIN STATION – AGHIOU KONSTANTINOU SQUARE

The following works are still pending:

  • Door installation at the E/M floor.

The following works are in progress:

  • Brick structures at the ticketing and platform levels
  • Waterproofing at street level
  • Plastering works at the platform level
  • Cleaning works

UNDERGROUND PART OF THE STATION

The following works have been completed:

  • Concreting of the permanent lining, parapet walls and platform slab.

STAIRCASE GALLERIES

The following works have been completed:

  • Concreting of the permanent lining and works related to secondary concreting.

KORAI SQUARE ENTRANCE AND ACCESS GALLERY

 The following works have been completed:

  • Concreting of the permanent lining, secondary concrete and waterproofing.

The following works are in progress:

  • Waterproofing of the top of the open trench.

BAKOYIANNI SQUARE ENTRANCE AND ACCESS GALLERY

 The following works have been completed:

  • Waterproofing and concreting of the permanent lining (still pending is the waterproofing detail at the terminating point, at street level)
  • Secondary concrete at the staircases.

The following works are put on hold:

  • Secondary concrete at the access gallery.

 The following works are in progress:

  • Removal of the 2nd row of metal struts

 RALLIOS SHAFT – VENTILATION TUNNEL

The following works have been completed:

  • Concreting of the permanent lining.
