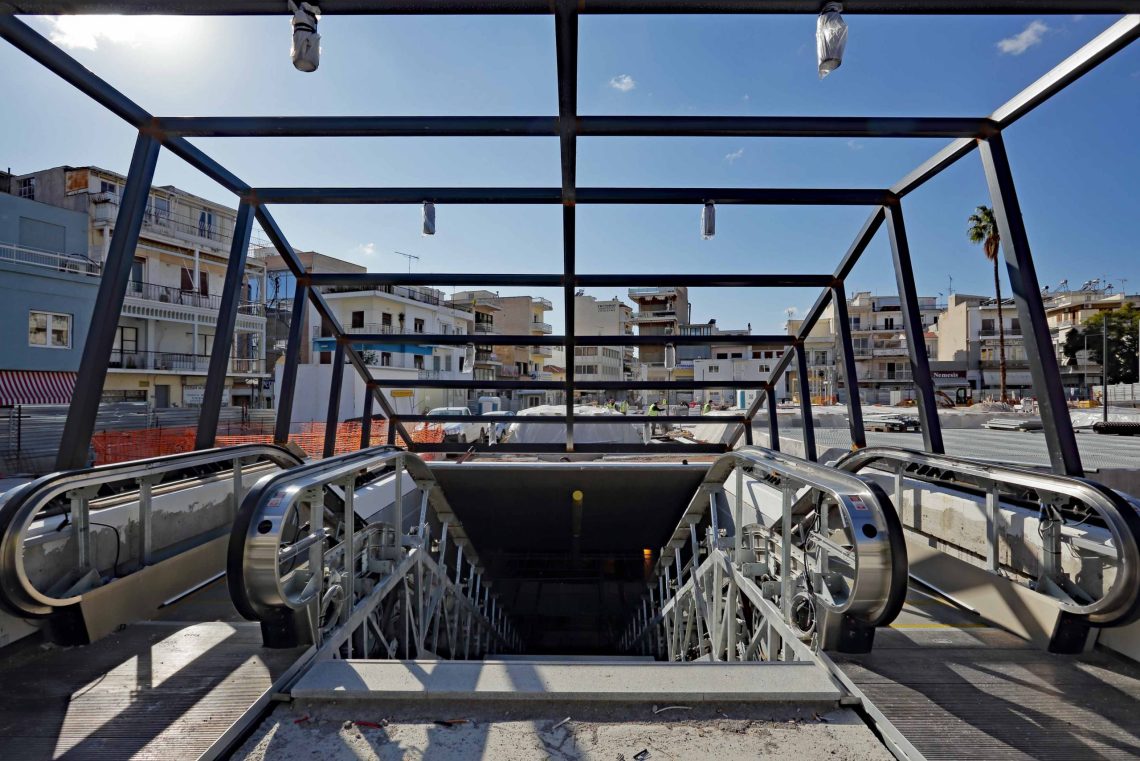

Piraeus Project progress

JANUARY 2020



AGHIA VARVARA STATION

The following works are in progress:

  • Installation of lifts in the station
  • Wall and columns cladding (metal, glass etc.)
  • Installation of handrails
  • Other architectural finishes
  • Installation of station and other signs
  • Installation of a fountain
  • Planting and irrigation system
  • Installation of false ceilings at the ticketing level.

MEGALOU ALEXANDROU SHAFT

Works have been completed.

 The following works are still pending:

  • Planting (street level)

TAXIARCHON SHAFT

The following works are in progress:

  • Painting works
  • Installation of metal structures
  • Configuration at street level

KORYDALLOS STATION

The following works are in progress:

  • Wall and Columns cladding
  • Installation of false ceilings
  • Installation of lift at street level
  • Installation of handrails
  • Installation of balustrades
  • Installation of Station entrances’ sheds
  • Installation of lift at street level
  • Configuration at street level (Eleftherias Square)

NIKEA STATION

MAIN STATION

The following works are in progress:

  • Final reinstatement of the surrounding area
  • Painting of parapet walls at terminating points, at street level (level 0)
  • False ceilings
  • Cladding of vertical elements using metal panels

MANIATIKA STATION

OPEN CUT OF THE STATION

The following works have been completed:

  • Permanent lining of foundation (level -4)
  • Permanent lining of E/M slab (level -3)
  • Permanent lining of ticketing level slab (level -2)
  • Permanent lining of staircase S4

 The following works are in progress:

  • Waterproofing of perimeter walls
  • Permanent lining of perimeter walls, columns and intermediate slabs.

PIRAEUS STATION

STATION

The following works have been completed:

  • Installation and prestressing of struts for temporary retaining at all levels.

The following works are in progress:

  • Installation of reinforcement and concreting at roof bay #4.

DIMOTIKO THEATRO STATION

MAIN STATION – AGHIOU KONSTANTINOU SQUARE

The following works are still pending:

  • Door installation at the E/M floor
  • Waterproofing at street level

The following works are in progress:

  • Filing concrete underneath the platforms
  • Industrial floor paving at E/M floor
  • Masonry walls at ticketing level

UNDERGROUND PART OF THE STATION

The following works have been completed:

  • Concreting of the permanent lining, parapet walls and platform slab.
