ΕΛΛΗΝΙΚΟ ΜΕΤΡΟ Α.Ε. – ELLINIKO METRO S.A.

Piraeus Project progress

DECEMBER 2019

DOUBLE TRACK NATM START TUNNEL

Works have been completed.

KOMNINOU SHAFT

The following works have been completed:

  • Masonry, plastering, door installation, industrial floor, painting, grid installation at street level, staircase balustrades, hatch
  • Street level reinstatement

AGHIA VARVARA STATION

The following works are in progress:

  • Installation of lifts in the station
  • Wall and columns cladding (metal, glass etc.)
  • Installation of handrails
  • Other architectural finishes
  • Installation of station and other signs
  • Installation of a fountain
  • Planting and irrigation system
  • Installation of false ceilings at the ticketing level.

MEGALOU ALEXANDROU SHAFT

Works have been completed.

The following works are still pending:

  • Planting (street level)

TAXIARCHON SHAFT

The following works are in progress:

  • Painting works
  • Filling works and industrial floors
  • Installation of doors
  • Installation of ceramic tiles
  • Installation of metal structures

KORYDALLOS STATION

The following works are in progress:

  • Installation of doors
  • Installation of granites or marbles
  • Wall and Columns cladding
  • Installation of false ceilings
  • Installation of lift at street level
  • Installation of handrails
  • Installation of balustrades

PISSIDIAS SHAFT

The following works are in progress:

  • Handrails – balustrades at the emergency staircase
  • Final reinstatement at street level (removal – dismantling).

NIKEA STATION

MAIN STATION

The following works are in progress:

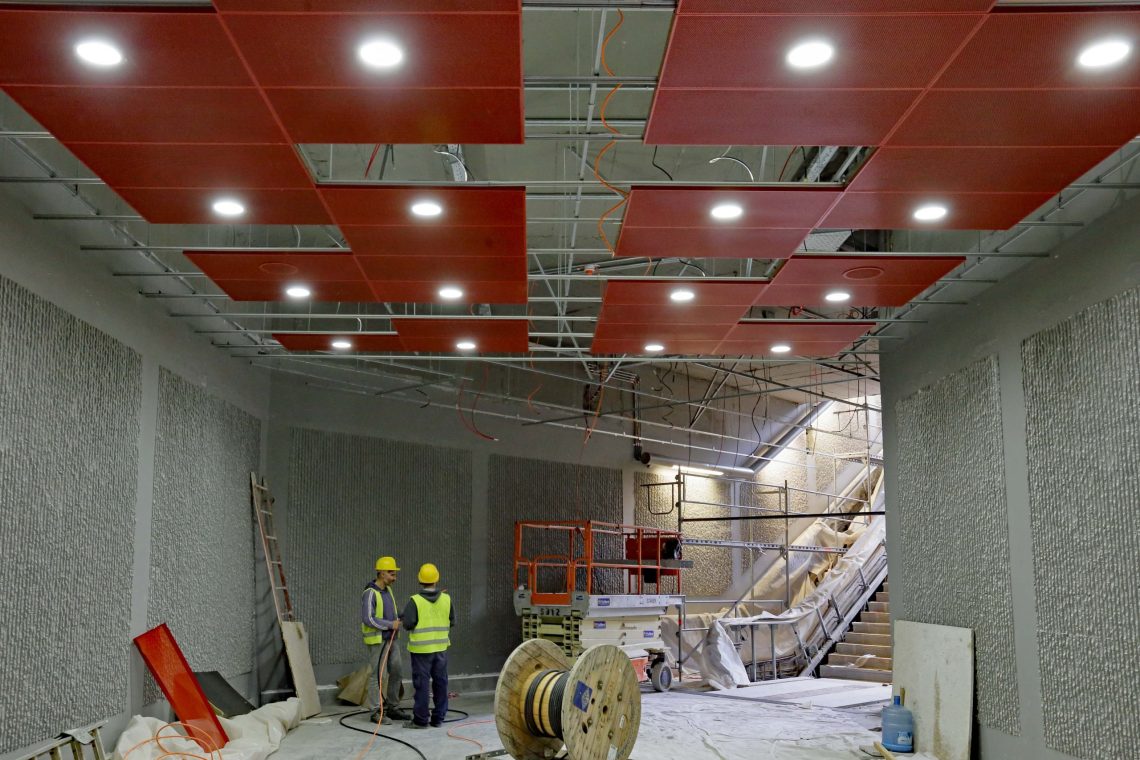

  • Roof cladding using horizontal false ceiling panels at several levels of the Station
  • Wall cladding using metal panels at level -3 of the platforms
  • Final reinstatement of the surrounding area at street level (slab paving – minor structures’ concrete)
  • Installation of metal shed at the central entrance of the Station
  • Installation of metal structure to support the glass panels of the PSN lifts
  • Preliminary works for the installation of fire rated glass panels at the public staircases, at level -3 of the platforms
  • Preliminary works for the installation of aluminum glass panels in public areas, at level -1 of the E/M floor.

MANIATIKA STATION

OPEN CUT OF THE STATION

The following works have been completed:

  • Permanent lining of foundation (level -4)
  • Permanent lining of E/M slab (level -3)
  • Permanent lining of staircase S4

DIMOTIKO THEATRO STATION

MAIN STATION – AGHIOU KONSTANTINOU SQUARE

The following works are still pending:

  • Door installation at the E/M floor
  • Waterproofing at street level

The following works are in progress:

  • Concreting of the east shaft termination
  • Filing concrete underneath the platforms.
